The New Cathedral

A cathedral in ironwood, built together.

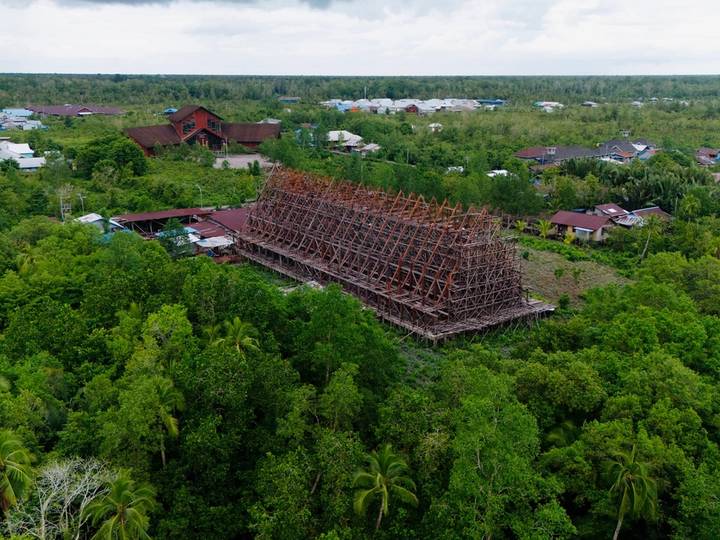

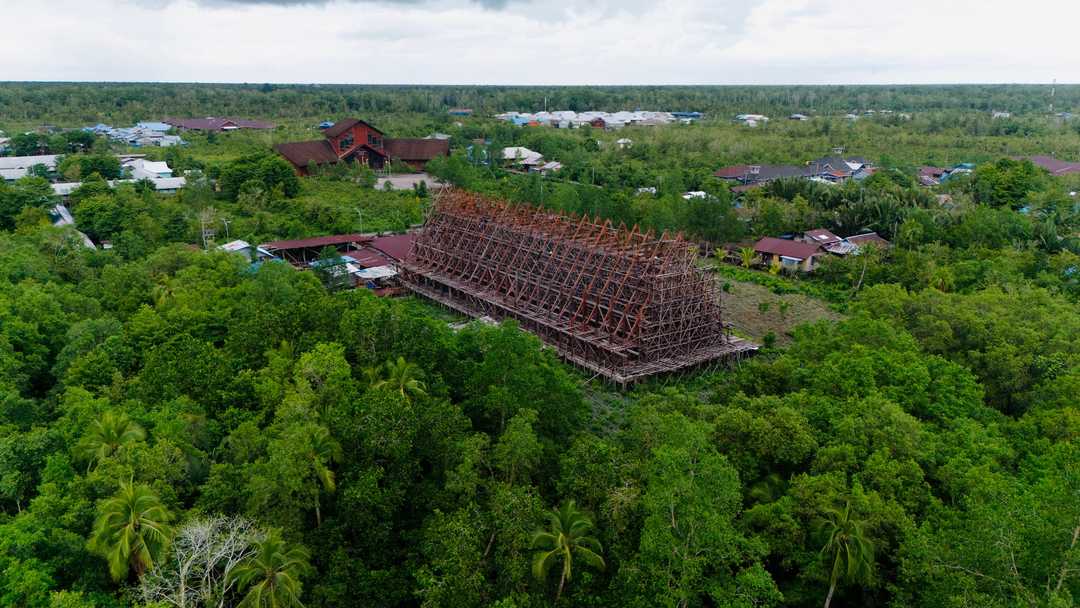

Ironwood posts and trusses of the new Cathedral of the Holy Cross seen from the air, before the roof battens
Posts and trusses of the new cathedral, 26 May 2026. Parish communications team

The new cathedral measures 60 by 23 metres and stands on concrete piles driven into the Agats swamp. Its whole structure is ironwood, a timber that withstands salt water and humidity. Construction began in 2015, paused, and resumed in 2025. By June 2026 the main structure was complete; 35 workers were finishing the building and 16 the interior, all in Asmat timber and all by hand.

Current stage: Purlins and trusses.

Who is building it

The cathedral is funded by parishioners, the Asmat Regency government, voluntary gifts from Catholic civil servants, and donors. The Bishop calls it a home for all of us: the parish, the workers, the government, and the donors.

The tree of hope

On 21 June 2026 Vice President Gibran Rakabuming Raka visited the site and planted a cypress as a tree of hope. Rows of cypress will surround the cathedral.

Timber

The whole structure is ironwood; floors, walls and ceilings are local Asmat timber, worked by hand.

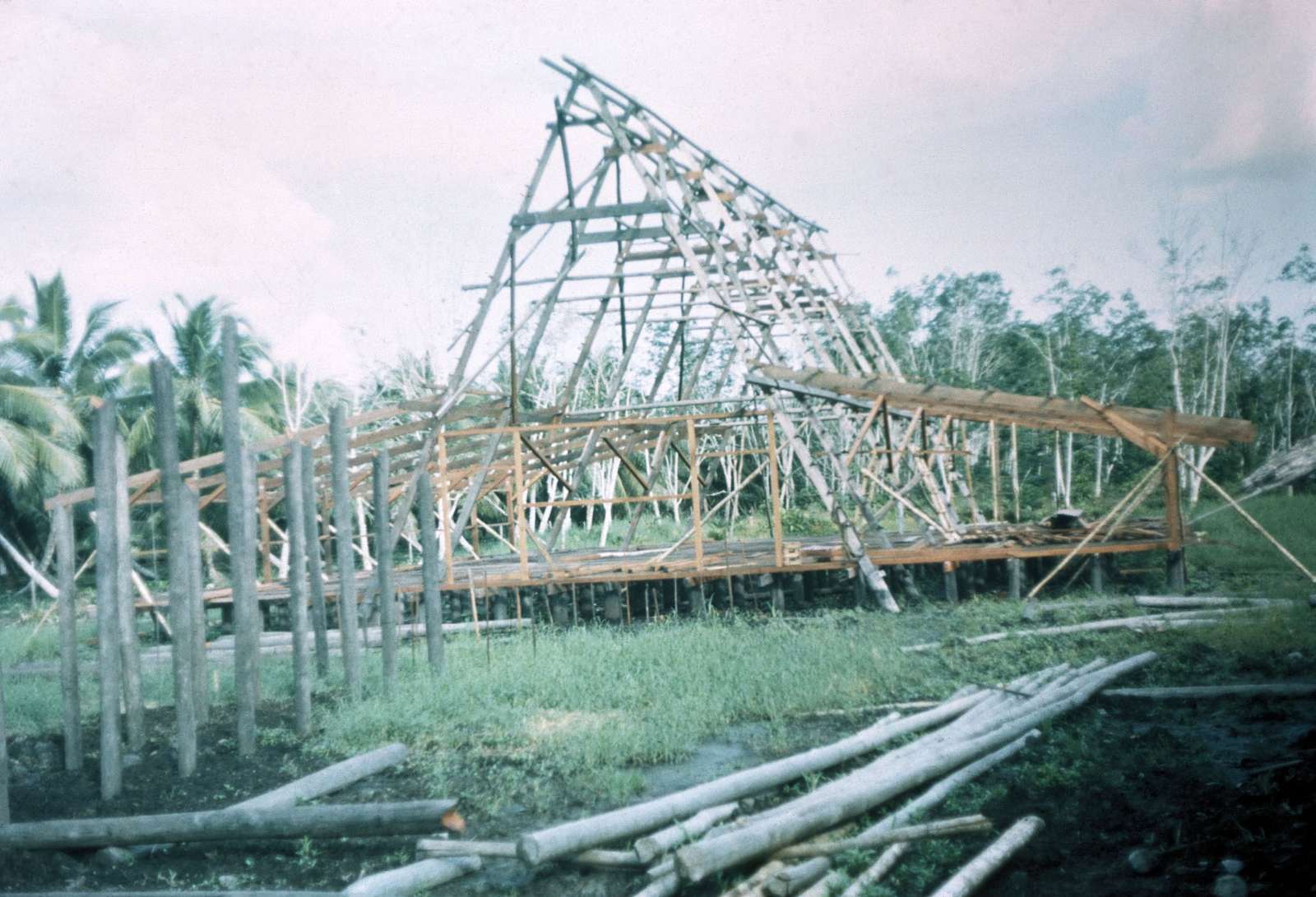

The A-frame of the present cathedral under construction on timber piles, with logs in the water and palms around
The new cathedral follows the design of the old church. Construction of the present cathedral. Parish communications team

Built from this land's timber, by the people's own hands.

    1. 2015

      Construction begins.

    1. Work pauses for lack of funds.

    1. 2025

      Work resumes with the parish, the Asmat Regency government, and donors.

    1. 10 June 2026

      The roof purlins are blessed.

      On 10 June 2026 the roof purlins were blessed at a Mass celebrated by Fr. Yulius Hirnawan Christyanto, OSC, with the Bishop present.

    2. 21 June 2026

      The tree of hope.

      On 21 June 2026 Vice President Gibran Rakabuming Raka visited the site and planted a cypress as a tree of hope. Rows of cypress will surround the cathedral.

    3. 2026

      Main structure complete. Roof and interior in Asmat timber, 51 workers on site.

    1. Dedication of the cathedral.

Construction stages

  • Complete
  • In progress
  • Planned
  1. 01

    Concrete piles and foundation

    Complete

  2. 02

    Foundation reinforcement

    Complete

  3. 03

    Floor deck and frame

    Complete

  4. 04

    Main posts and frame

    Complete

  5. 05

    Purlins and trusses

    In progress

    Blessed on

  6. 06

    Battens and roof

    In progress

  7. 07

    Walls, ceiling and timber interior

    In progress

  8. 08

    Carving, altar and liturgical furnishings

    Planned

  9. 09

    Grounds, cypress trees and dedication

    Planned

    Cypress planted on

“All the timber is from here. All of it is done by hand.”

— a carpenter on the new cathedral, June 2026

Building Journal

June 2026

Photograph to follow.

The tree of hope

On 21 June 2026 Vice President Gibran Rakabuming Raka visited the site and planted a cypress as a tree of hope. Rows of cypress will surround the cathedral.

October 2025

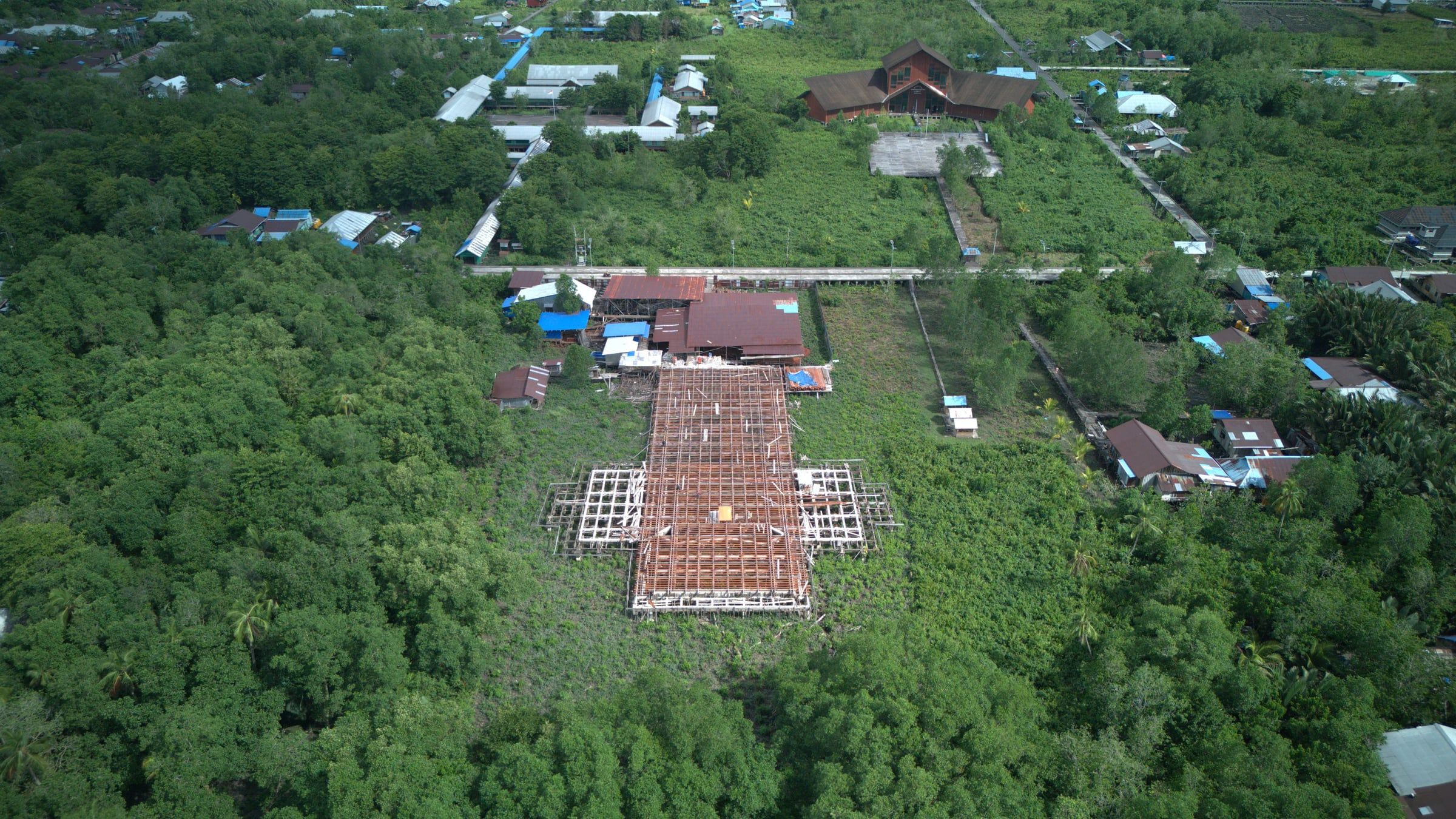

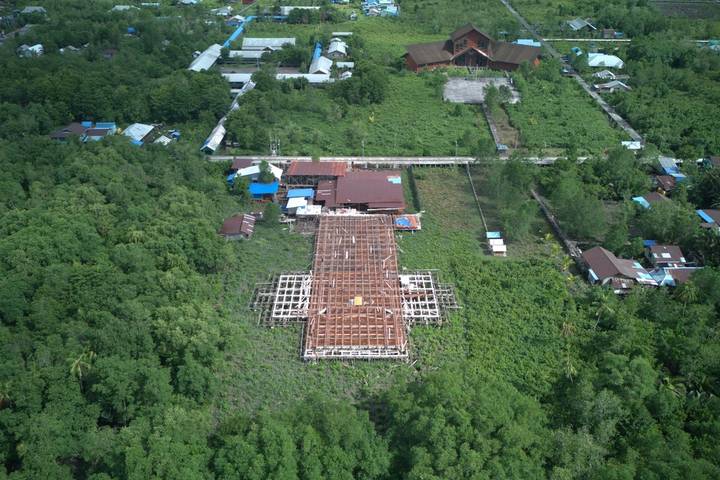

Lantai mulai dipasang

Lantai mulai dipasang

September 2025

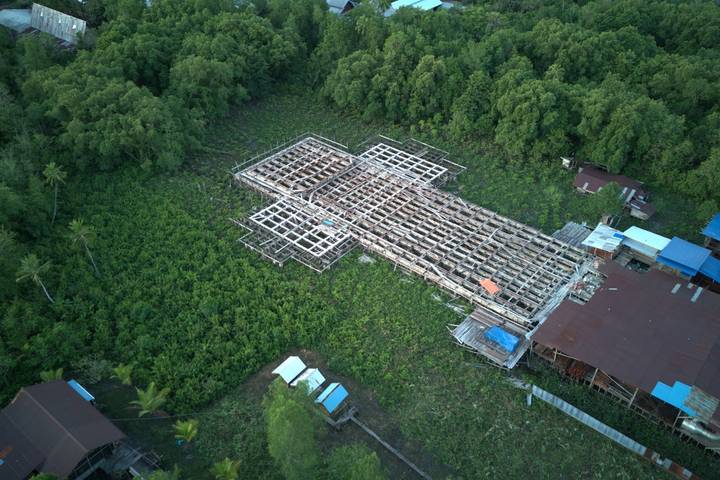

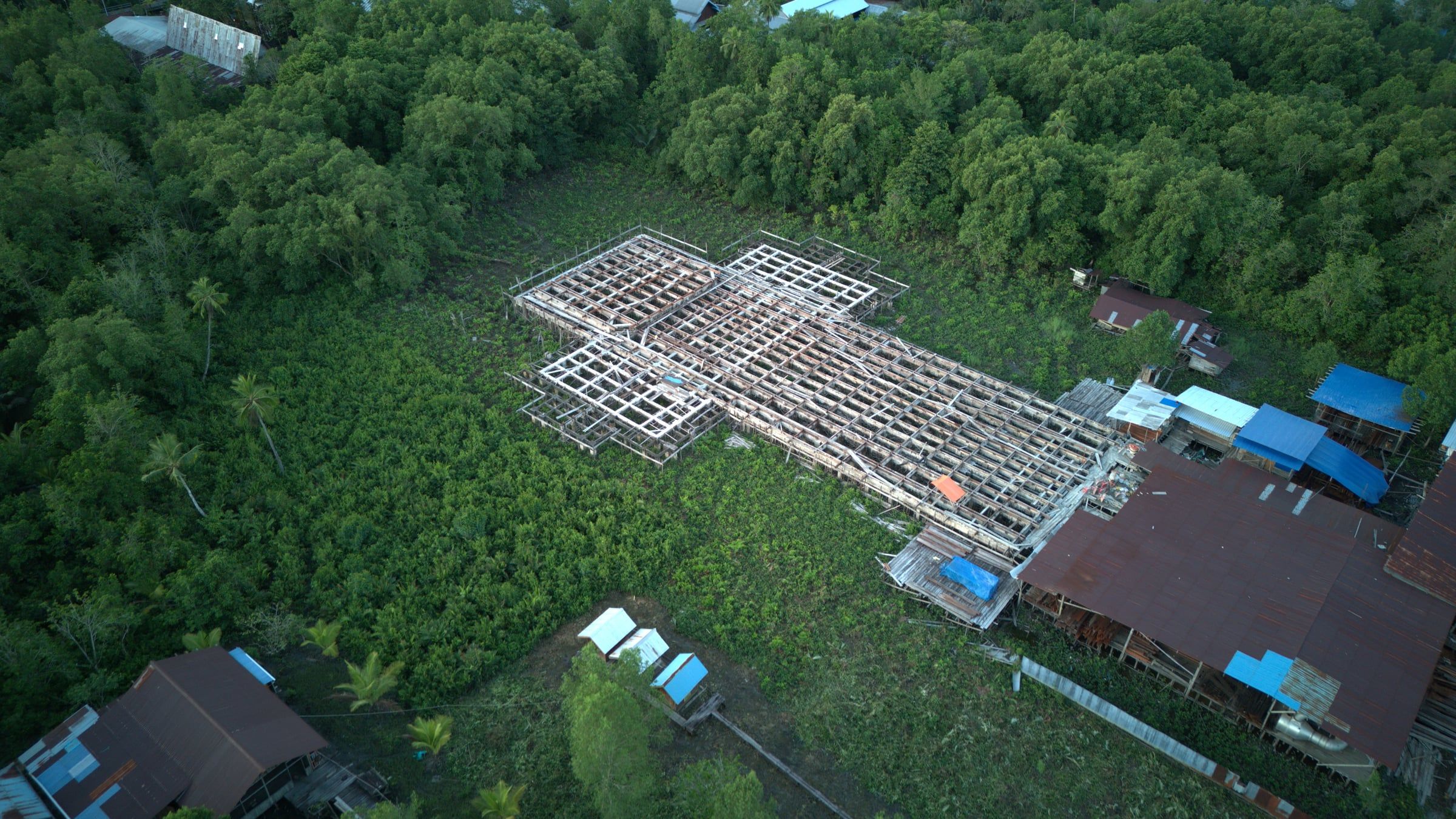

Rangka lantai berbentuk salib

Rangka lantai berbentuk salib

Those who are building it

Parishioners, donors and volunteers who chose to be named. This cathedral is a home for all of us.

Names appear after review by the parish communications team.

Next stages

  1. 05

    Purlins and trusses — In progress

  2. 06

    Battens and roof — In progress

  3. 07

    Walls, ceiling and timber interior — In progress

  4. 08

    Carving, altar and liturgical furnishings — Planned

  5. 09

    Grounds, cypress trees and dedication — Planned

Gifts are voluntary and given according to one’s means. The only official account and QRIS code are those shown on the Donate page and in the church.

New Cathedral of the Holy Cross, Agats: 60 by 23 metres, concrete-pile foundation, ironwood structure, begun 2015, resumed 2025, structure complete June 2026, roof and interior in local Asmat timber, located in Agats, Asmat Regency, South Papua.
